Request Consultation
Liquid Cooling for AI Data Centres · Part 1

Liquid Cooling, Explained: Five Technologies and Where Each Fits

Five liquid cooling technologies for AI data centres: rear doors, single- and two-phase cold plates, single- and two-phase immersion. What each is, where it fits, and what commissioning must prove before the first rack depends on it.

By Team@MCE Updated 6 min read

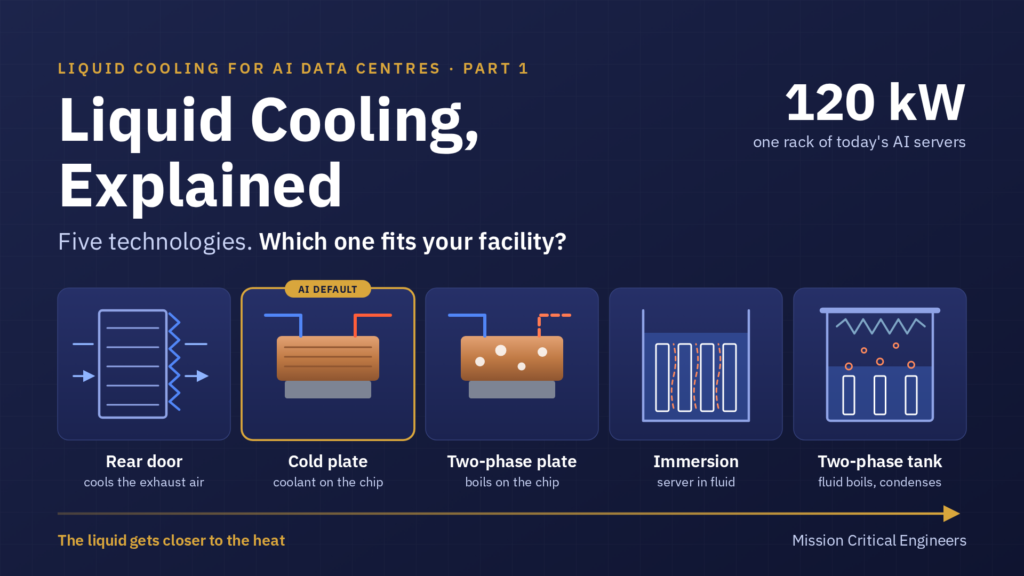

Liquid Cooling, Explained: five liquid cooling technologies, from rear-door heat exchangers to two-phase immersion

A single rack of today’s AI servers draws about 120 kW. Most data halls were built for racks that draw a fraction of that.

Choosing the technology is the easy part. Proving it works before the first AI rack depends on it is where projects succeed or fail.

At a Glance

Servers change?Heat to liquidBest fit today
1. Rear doorNoNearly all of it, from the exhaust air; none at the chipExisting halls, mixed hardware
2. Direct-to-chip, single-phaseCold plates fittedMost (60–90%)AI racks, new builds and retrofits
3. Direct-to-chip, two-phaseCold plates fittedMostNext-generation chips, early adopters
4. Single-phase immersionApproved for fluid, no fansNearly allEdge, crypto, some HPC
5. Two-phase immersionApproved for fluid, no fansNearly allSpecialist; fluid supply in flux

Why Air Runs Out

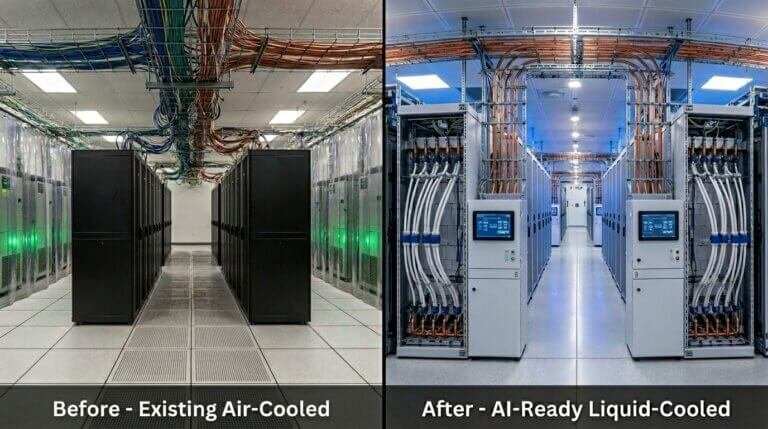

For the same rise in temperature, a litre of water carries about 3,500 times more heat than a litre of air. Up to about 20 to 30 kW a rack, moving more air works. Beyond that, the fans, airflow and floor space stop making sense, and the chips now arrive designed for liquid: NVIDIA’s Vera Rubin NVL72 rack is 100 percent liquid-cooled.

Liquid cooling brings liquid closer to the heat. The closer it gets, the more heat it takes away, and the more the server has to change.

The Five Technologies, from the Rack Door to the Whole Server

1 Rear-door heat exchanger

A water-cooled coil replaces the rack’s back door and cools the servers’ exhaust air.

20–80 kW per rack
LIQUID COOLING · 1 OF 5Rear-door heat exchanger CDU or chilled-water loop Cool room air in Servers keep their fans Water coil in the rear door Air out, close to room temperature Cool air Hot air Cool water Warm water Illustration for the concept, not a detailed design. © Mission Critical Engineers™ LIQUID COOLING · 1 OF 5Rear-door heat exchanger CDU or chilled-water loop Cool air in Servers keep their fans Water coil in the rear door Air out, near room temperature Cool air Hot air Cool water Warm water Illustration for the concept, not a detailed design. © Mission Critical Engineers™
Follow the air: cool in at the front, hot through the servers, cooled again by the door.

About the diagrams: illustrations for the concept, simplified to show how each technology works, not detailed designs. A real system adds the controls, valves, redundancy and safeties every site needs.

Where it fits
Existing halls that need more density without changing servers, and alongside cold plates to catch the heat they leave.
The catch
The chip is still cooled by air, so a rear door alone cannot serve the newest AI processors.
What commissioning must prove
Water supplied above the dew point, with condensation alarms; each door’s flow balanced; the room holds temperature with one door’s water shut off.

2 Direct-to-chip, single-phase

Coolant flows through a copper cold plate on each processor; a CDU pumps it and keeps it apart from the building’s water.

60–90% of the heat to liquid
LIQUID COOLING · 2 OF 5Direct-to-chip, single-phase CDU pump · heat exchanger Fans still cool memory and drives Dripless quick disconnects Rack manifold to building water Cold plate on each processor Cool air Warm air Coolant supply Coolant return Building water Illustration for the concept, not a detailed design. © Mission Critical Engineers™ LIQUID COOLING · 2 OF 5Direct-to-chip, single-phase CDU pump · heat exchanger to building water Fans still cool memory and drives Dripless quick disconnects Cold plate on each processor Rack manifold Cool air Coolant supply Coolant return Building water Illustration for the concept, not a detailed design. © Mission Critical Engineers™
Follow the coolant from the rack manifold to each cold plate and back.
Where it fits
Today’s default for AI training and inference; it is what NVIDIA, AMD and the major server makers design for.
The catch
Water now runs inside the server, through channels a fraction of a millimetre wide. A dirty loop fouls the plates, and a leak must be caught and isolated fast.
What commissioning must prove
The loop flushed and filtered to the cold-plate maker’s cleanliness limit before any server is connected; coolant chemistry checked; leak detection trips and isolates; a pump, or a whole CDU, failed under full load while the racks stay below throttling.

From the Chip to the Roof

Two CDUs (N+1) on looped headers: a pump, a valve or a whole CDU can come out with the racks running.

3 Direct-to-chip, two-phase

A non-conductive refrigerant boils in the cold plate, like a kettle, and is condensed back to liquid in the CDU.

1.5–2 kW+ per chip: the next generation of processors
LIQUID COOLING · 3 OF 5Direct-to-chip, two-phase GPU Condenser in the CDU Refrigerant boils in the cold plate Vapour and liquid carry the heat Building water Liquid returns via receiver and pump Liquid refrigerant Vapour + liquid Building water Illustration for the concept, not a detailed design. © Mission Critical Engineers™ LIQUID COOLING · 3 OF 5Direct-to-chip, two-phase Condenser in the CDU GPU Building water Vapour and liquid carry the heat Liquid returns via receiver and pump Refrigerant boils in the cold plate Liquid refrigerant Vapour + liquid Building water Illustration for the concept, not a detailed design. © Mission Critical Engineers™
The dashed line carries vapour and liquid out; the solid line brings liquid back.
Where it fits
The next generation of chips. A leak will not short the electronics.
The catch
It is early: the suppliers are small, and refrigerants bring their own regulations.
What commissioning must prove
Leak-tight, with the right refrigerant charge; refrigerant leak detection works; the condenser holds at the warmest building-water temperature; pump failover under load.

4 Single-phase immersion

Whole servers stand in an open tank of non-conductive fluid, under a lid; the fluid is pumped through a heat exchanger.

No server fans the fluid touches every part
LIQUID COOLING · 4 OF 5Single-phase immersion CDU pump · heat exchanger Dry cooler Servers stand in fluid; no fans Warm fluid out at the top Cooled fluid returns low Heavy: check the floor loading under the tank Dielectric fluid Warm fluid out Cooled fluid back Building water Illustration for the concept, not a detailed design. © Mission Critical Engineers™ LIQUID COOLING · 4 OF 5Single-phase immersion CDU pump + heat exchanger Dry cooler, outside Servers stand in fluid; no fans Warm fluid out at top Heavy: check the floor loading Cooled fluid returns low Dielectric fluid Warm fluid out Cooled fluid back Building water Illustration for the concept, not a detailed design. © Mission Critical Engineers™
Warm fluid leaves near the top; cooled fluid returns low.
Where it fits
Edge sites, crypto mining and some high-performance computing, where silent, fan-free operation and density matter most.
The catch
Tanks are heavy and servers must be approved for the fluid. Maintenance means lifting hardware out of a bath.
What commissioning must prove
Floor loading confirmed; every component approved for the fluid, cables, labels and thermal pads included; filtration works; pump failover with the tank temperature held.

5 Two-phase immersion

Servers sit in a sealed tank of fluid that boils on the components and condenses on a coil under the lid.

Fluid supply in flux after the 2025 PFAS exit
LIQUID COOLING · 5 OF 5Two-phase immersion Dry cooler Sealed lid Coil condenses it; drops fall back Vapour rises Fluid boils on the hot parts Building water Boiling fluid Vapour Building water in Building water out Illustration for the concept, not a detailed design. © Mission Critical Engineers™ LIQUID COOLING · 5 OF 5Two-phase immersion Dry cooler Sealed lid Coil condenses the vapour; drops fall back Vapour rises Fluid boils on the hot parts Boiling fluid Vapour Building water in Building water out Illustration for the concept, not a detailed design. © Mission Critical Engineers™
Bubbles rise off the servers; condensate falls back from the coil.
Where it fits
Very high density, where the fluid supply allows. It is the most thermally efficient option on paper.
The catch
Its standard fluids are PFAS “forever chemicals.” 3M stopped making them at the end of 2025, and replacements are only starting production.
What commissioning must prove
Vapour stays in the tank and fluid loss is measured; lid interlocks work during service; the condenser holds at full load; the fluid supply is secured.

Which One Fits Your Facility?

If you are…Start withWhat to prove before go-live
Adding a few dense racks to an existing air-cooled hallRear-door heat exchangers. No server changes; you need water at the rack.Water above the dew point; the room holds with one door off
Building for current AI platformsSingle-phase direct-to-chip, with air or rear doors for the remaining heat.A clean loop before servers connect; rides through a pump or CDU failure at full load
Running silent, fan-free compute at the edgeSingle-phase immersion, if your floor and your hardware vendor allow it.Floor loading; every part approved for the fluid
Planning for chips beyond about 2 kWKeep two-phase direct-to-chip on the list; it is still early.Leak-tight with the right charge; condenser holds at the warmest water
Considering two-phase immersionWait until the replacement fluids prove their supply and approvals.Vapour stays in the tank; fluid supply secured

The market has already chosen its default. Single-phase direct-to-chip leads the analysts’ splits, and TrendForce estimates liquid cooling at about a third of high-end AI infrastructure in 2025, rising past half in 2026.

Three Things That Change for the Owner

There is still air. A liquid-cooled hall still needs air cooling (immersion far less of it) for the heat the liquid misses and for everything else in the room. Plan both systems, and how they interact.

Your data centre gains a plumbing system. Coolant chemistry, filtration, flushing and leak detection become daily operations. A loop that is dirty on day one fouls the cold plates; one that is not monitored corrodes slowly.

The time to react shrinks. When a coolant pump stops, the chip has seconds, not minutes, before it starts to throttle — so little that ASHRAE has opened research to measure it. Redundancy, controls, and proving them under load before handover, matter more than ever.

That last point is where the hard questions sit, and where this series goes next.

Next month: what happens in the seconds after a cooling failure, and how to prove the system rides through it.

Commissioning Liquid Cooling with Mission Critical Engineers

MCE commissions liquid-cooled AI data centres. We prove the loop is clean, the leak detection isolates and the system rides through a pump or CDU failure at full load, before the first rack depends on it.
